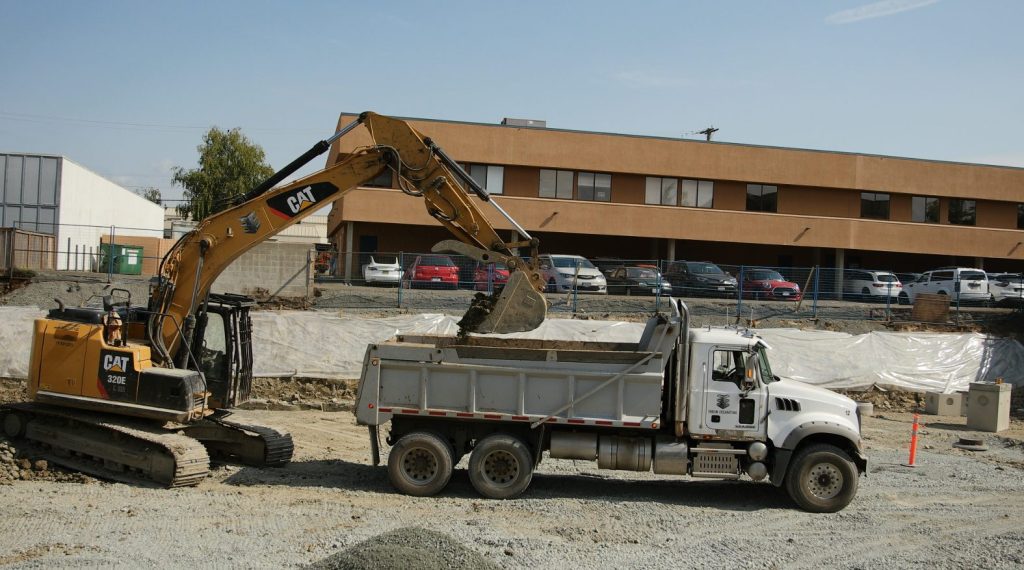

For developers and general contractors across Southern Vancouver Island, the excavation phase is the heartbeat of a project schedule. Whether you are breaking ground on a mid-rise in the city core or managing a multi-unit subdivision in the Westshore, the efficiency of material movement dictates the timeline for every subsequent trade. When trucks sit idle or cycle times begin to stretch, the resulting delays create a ripple effect that can compromise the entire construction window.
A primary goal for any commercial excavation is the seamless flow of material. However, Greater Victoria presents unique logistical frictions that can erode a timeline if not managed with local expertise. Moving thousands of cubic meters of fill requires a strategic approach to the regional bottlenecks that define our local geography.
The Impact of Site Staging
Effective site management starts with the footprint. In urban centers like Victoria or the denser parts of Saanich and Langford, space is a premium commodity. A site that is poorly staged leads to a cascade of inefficiencies. If an excavator is waiting for a truck to back into a tight spot, or if a truck is waiting for a machine to clear a path, the operation is sub-optimal. These minutes add up over the course of a day, leading to a significant reduction in total material moved.
Municipal permit awareness is a critical component of this planning. Within the City of Victoria, for example, the use of the right-of-way for staging or loading often carries a daily fee for arterial lane occupation. These costs are a necessary part of doing business, but they become a liability when the excavation phase drags on. A contractor who understands how to maximize every square meter of the site ensures that these permits are active for the shortest duration possible. By focusing on high-volume loading and maintaining clear access routes, a team can minimize the time spent occupying the street.
Related Post: Deep Excavation in Victoria, BC
Navigating the AAA Network
As the Capital Regional District continues to modernize, the physical environment around jobsites is changing. The expansion of the All Ages and Abilities (AAA) bike lane network—the specific standard used by the City of Victoria for protected cycling routes—has introduced new variables to the haul cycle. For a municipal engineer, the safety and integrity of this infrastructure are paramount.
For the contractor, these corridors represent critical interaction points. A heavy flow of tandem trucks or pony trailers crossing active cycling lanes requires a high level of coordination. This is not just about safety; it is about project continuity. Municipalities are quick to intervene if they perceive a site is not adequately managing its impact on public infrastructure. Professionalism in 2026 means maintaining a presence that respects these local nuances and avoids the friction that leads to municipal scrutiny.
Cycle-Time Analysis and the Afternoon Bottleneck
In Greater Victoria, the distance between the jobsite and the dump site is only half the story. The real metric is time. Regional traffic patterns across the Peninsula and Westshore are a constant variable that must be factored into the daily plan.
The efficiency of a haul cycle is often at the mercy of afternoon traffic. As volume builds on the Pat Bay Highway, the McKenzie interchange, and the Colwood Crawler, the time required for a single trip can double. This “3:00 PM wall” is a well-known hurdle for local operators.
Managing this requires a conscious approach to dispatching. It means analyzing the route to the gravel pit or the fill site and adjusting the truck-to-machine ratio as conditions change. If trucks are getting caught in Peninsula congestion, the site workflow needs to be flexible. The goal is to ensure the primary excavator remains productive while ensuring the hauling fleet is not spending excessive time in avoidable traffic.
Related Post: How Weather Conditions Affect Excavation Projects in Victoria, BC
Strategic Material Management
Efficiency is not just about what leaves the site; it is about what stays and how it is moved. On larger civil or commercial projects, the internal movement of aggregates and fill can be a major time-sink. This is where the choice of equipment and the sequencing of tasks become essential.
Decoupling tasks is how a high-performance contractor keeps the project moving forward even when external haul routes are congested. For example, focusing on internal grading or placing bedding material for utility trenches can keep the site productive during peak traffic hours when hauling out is less efficient. This approach ensures the project continues to advance regardless of external logistical pressures.
Partnering for Performance
Excavation is often the first major interaction a developer has with the local municipality and the surrounding neighborhood. It sets the tone for the rest of the build. Choosing a partner who understands the specific constraints of the 13 unique municipalities in Greater Victoria is essential for keeping a project on track. By focusing on cycle-time optimization, site staging, and municipal compliance, a contractor can successfully navigate the complexities of the Southern Vancouver Island market.
